Jenolan Caves Road

Reviewed

Project overview

Following the extreme weather event in March 2021, there have been significant impacts to Jenolan Caves Road at Hampton, Two Mile and Five Mile. Transport for NSW is undertaking extensive investigation and rehabilitation work to return the road to full capacity.

Latest news

July 2025 – Community update

Read how projects are progressing on Jenolan Caves Road in the July Community Update (PDF, 570.36 KB).

February 2025 - Detour in place for road closures on Jenolan Caves Road near Hampton

View the February notification (PDF, 236.85 KB) for more information.

December 2024 - Jenolan Caves Road near Hampton reopened to two-way traffic

November 2024 - Road closures on Jenolan Caves Road in December

View the November notification (PDF, 407.88 KB) for more information.

October 2024 - Road closures on Jenolan Caves Road near Hampton 11 -15 November

View the latest October notification (PDF, 434.14 KB) for more information.

July 2024 - Vital slope work the next step in restoring Jenolan Caves Road near Hampton

Read more in the media release.



Subscribe to stay up to date with the latest information about work being carried out on Jenolan Caves Road.

Project information

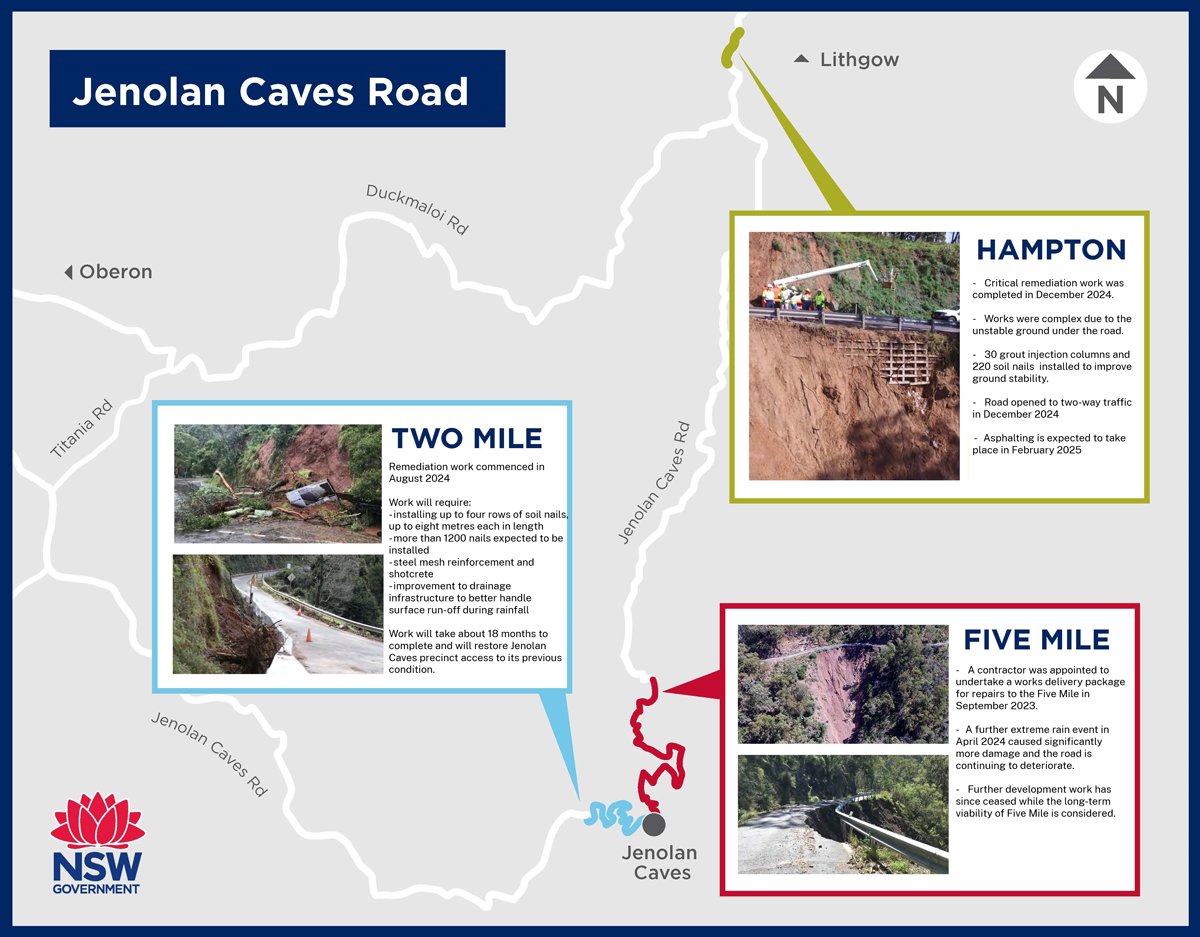

Jenolan Caves Road updated closures map December 2024

Hampton

The works at the Hampton slope were extensive and complex. Workers were required to abseil down the slope in order to complete the work, which involved replacing several culverts as well as the installation of more than 200 soil nails and shotcrete at two separate locations. Work at the Hampton slope was completed in July 2024, two months ahead of schedule.

Critical remediation work at Carlos Creek, near Hampton began in July 2024 following the completion of the Hampton downslope.

The works to repair Carlos Creek were complex due to the unstable ground under the road. To improve the ground stability the project included installing 30 grout injection columns and 220 soil nails.

Crews used four light-weight drill rigs, known as Marinis, during the work. The machines were lowered over the side of the slope which drastically reduced the number of road closures required to complete the work.

The work at Carlos Creek was completed in December 2024, three months ahead of schedule.

Jenolan Caves Road at Hampton is now open to two-way traffic for the first time in almost 4 years.

A final layer of asphalt through both project sites will be laid in early 2025.

Images of Hampton

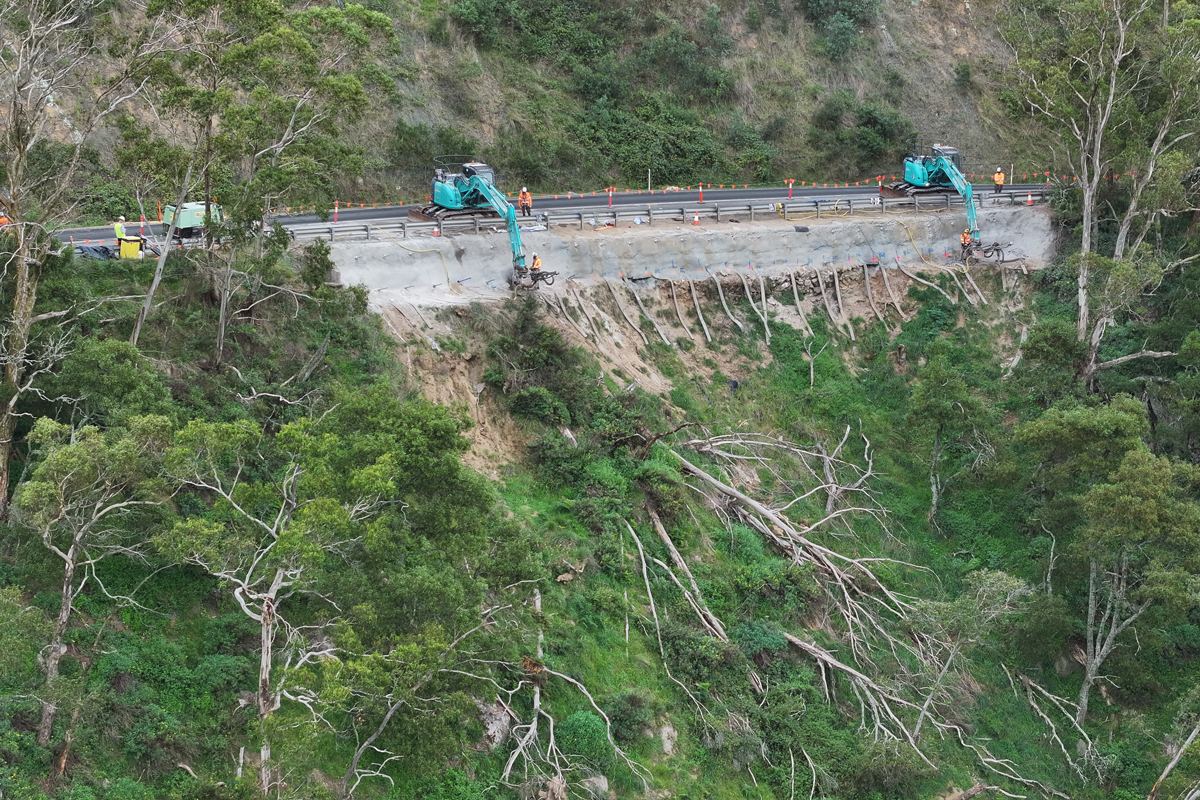

Hampton slope remediation project

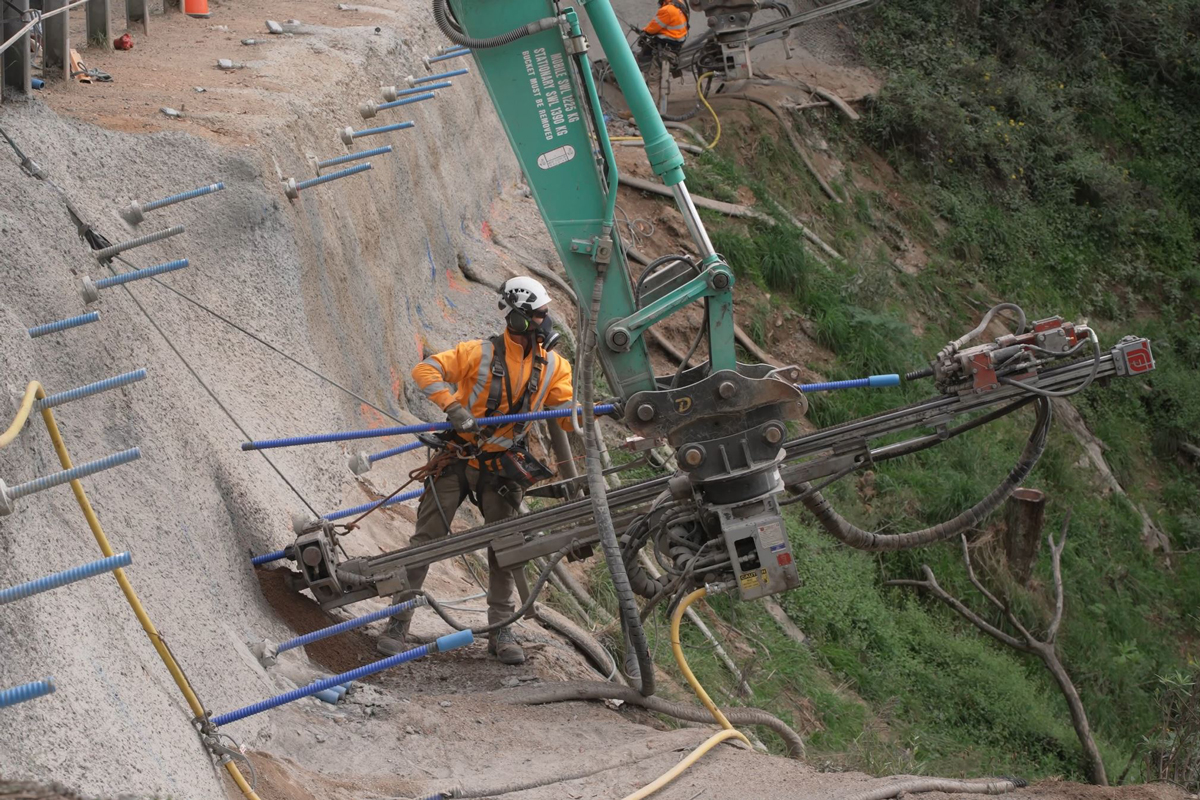

Hampton slope soil nailing

Soil nailing on the Carlos Creek project

Two Mile

Remediation work at Two Mile on Jenolan Caves Road commenced in August 2024.

Work will require the installation of up to four rows of soil nails, up to eight metres each in length, with more than 1200 nails expected to be installed at nine failure sites along the Two Mile. As well as using soil nails to repair the slope failures, we are improving drainage infrastructure to better handle surface run-off during rainfall.

This extensive remediation work will take about 18 months to complete and will restore access to the Jenolan Caves precinct to its previous condition.

Images from Two Mile

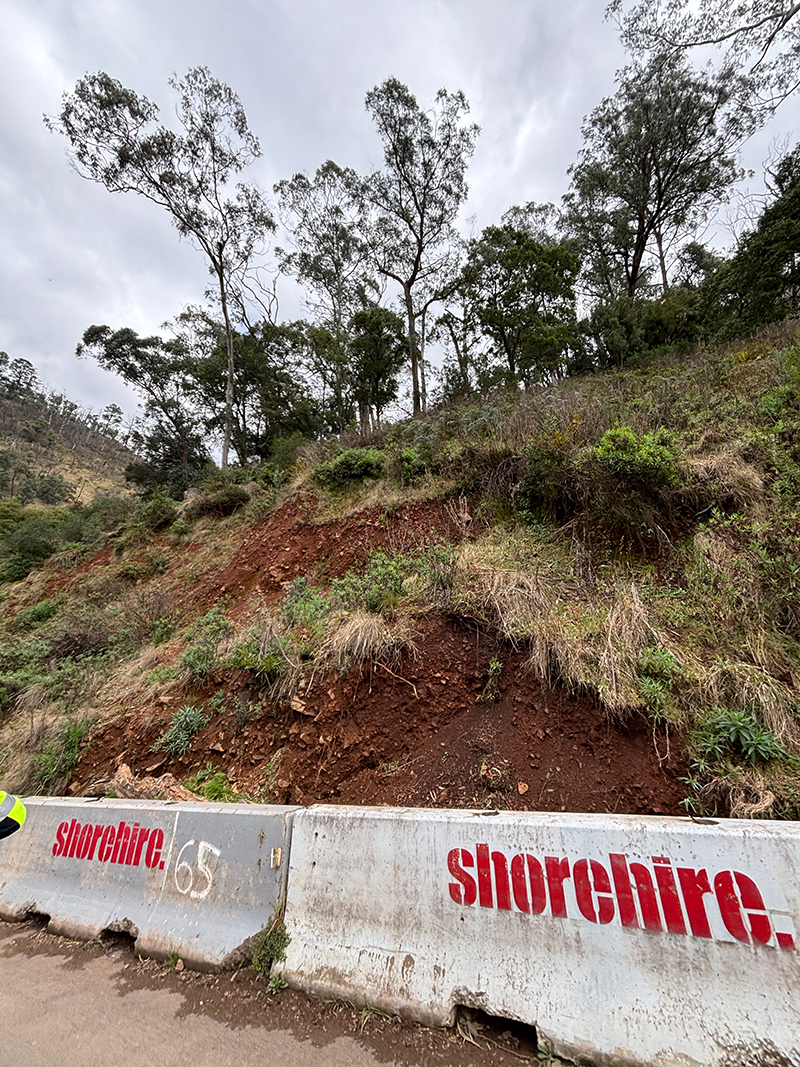

Two Mile Carpark failure prior to works commencing

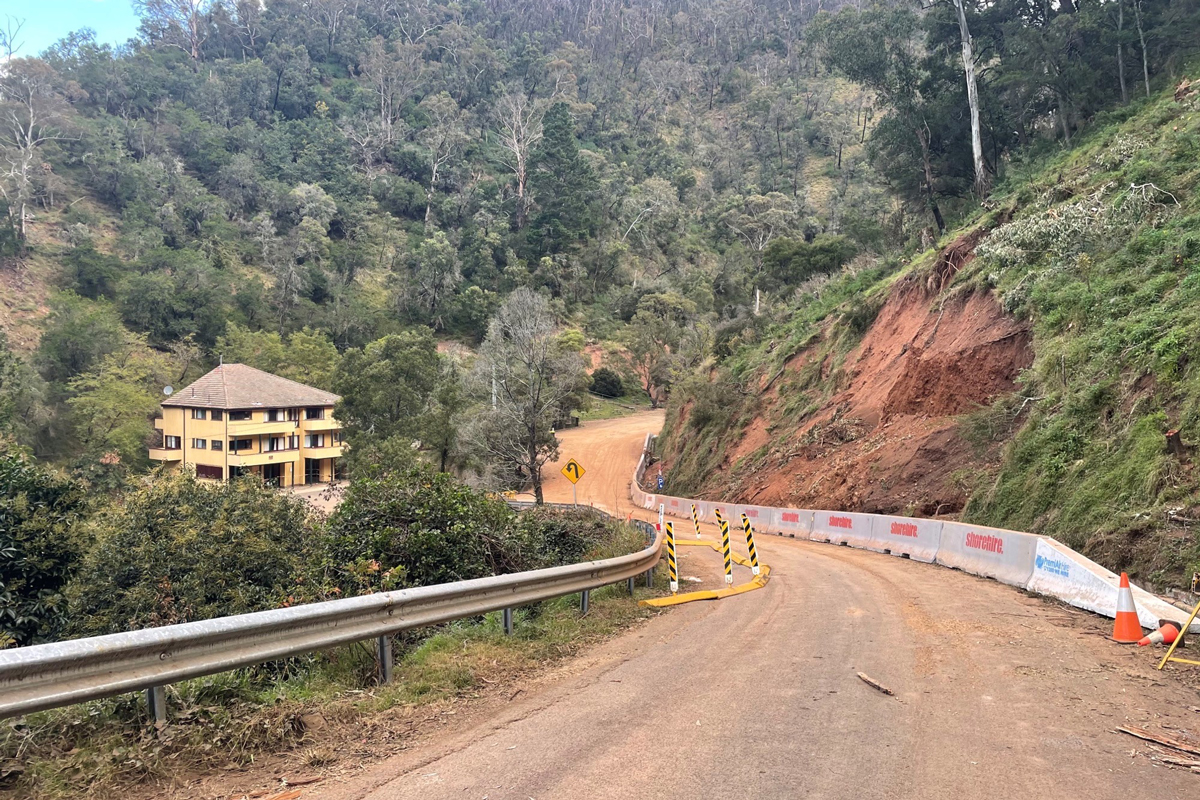

Two Mile Carpark failure prior to works commencing

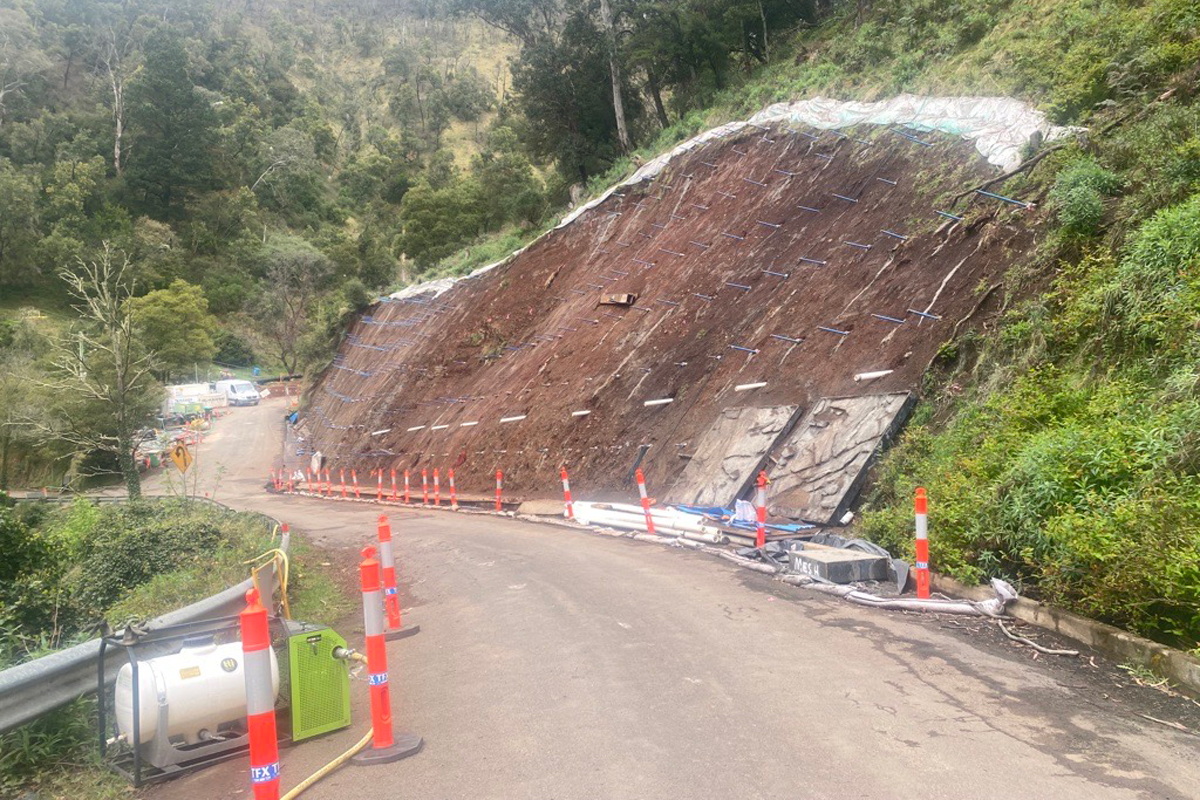

Two Mile Carpark failure remediation progressing

Five Mile

A contractor was appointed to undertake a works delivery package for repairs to the Five Mile in September 2023, however, a further extreme rain event in April 2024 caused significantly more damage and the road is continuing to deteriorate. Further development work has since ceased while the long-term viability of Five Mile is considered.

Images of Five Mile

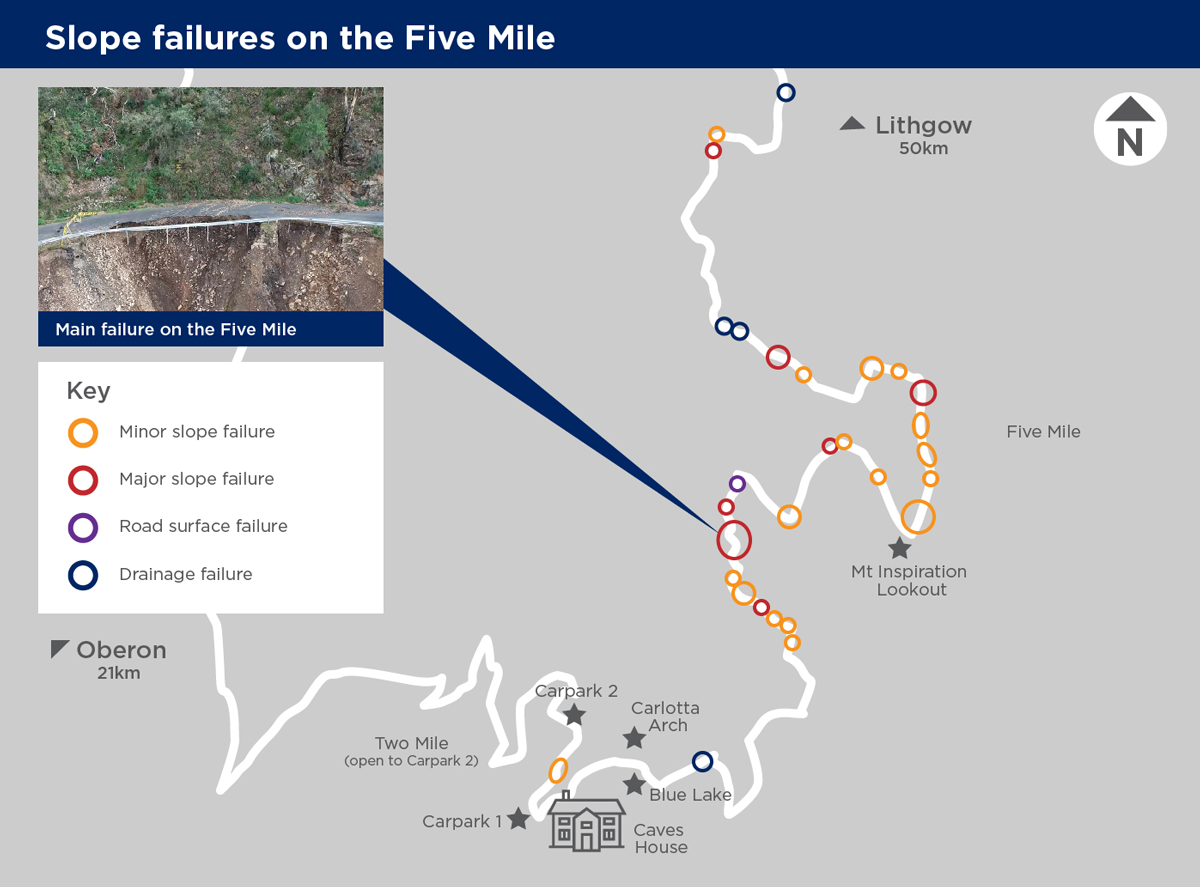

Slope failures on the Five Mile map

View larger version of map here (PDF, 429.76 KB).

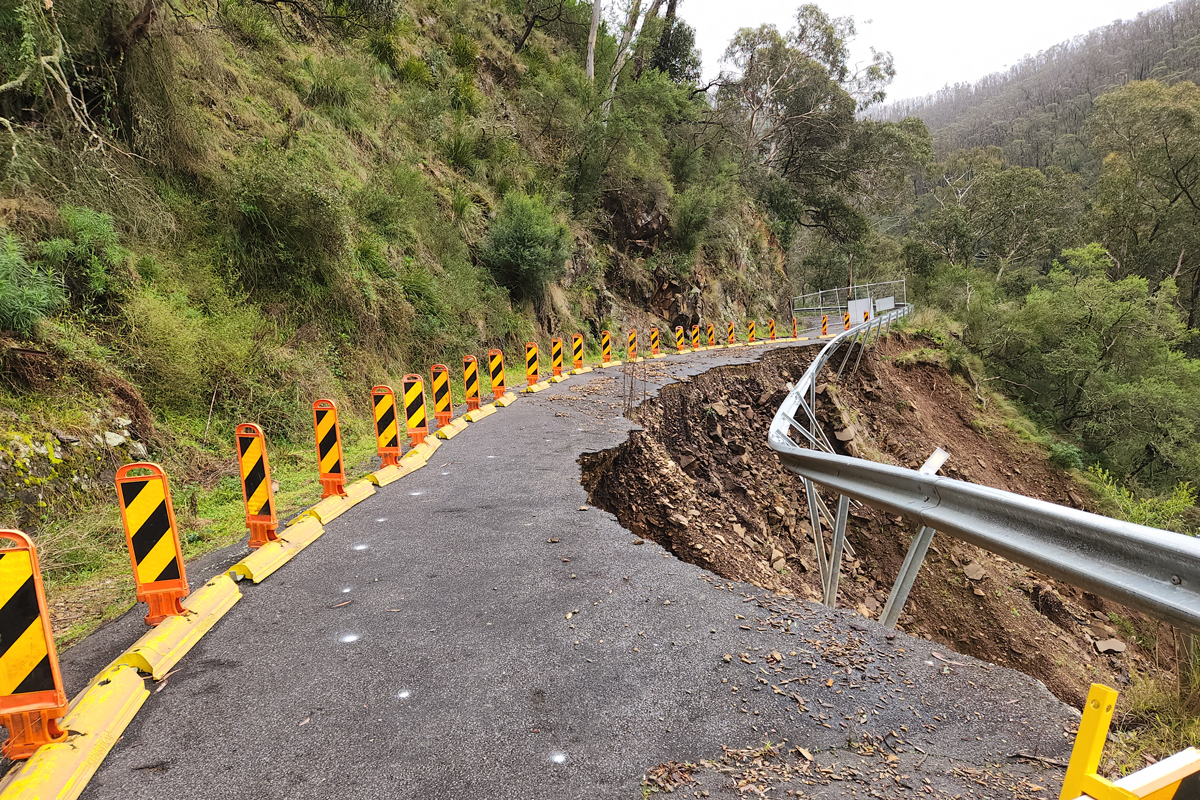

Five Mile main failure

Infographics and Diagrams

Impacts of flooding on Jenolan Caves Road



Image gallery

 Project documents

Some documents on this page may not comply with accessibility requirements (WCAG).

If you are having trouble accessing information in these documents, please contact us.



Traffic Alerts and Notifications

Community updates

REF Documents

Media releases

Contact us

For further information about this project, please contact:

Phone: 1800 167 499

Email: western.projects@transport.nsw.gov.au
